MTC
Anchor Handling Course
6.3Adjustment of Pressure Switches for Lock Pressure.
1.Adjust pressure to 115 bar.
Use horizontal adjusting screw on pump pressure compensatory valve.
2.Adjust pressure switch until green lamp on control panel comes on. Use alternative voltmeter and measure on cables for pressure switches.
7.Test Program – Periodical Control
Triplex Shark Jaw Type H-700
Triplex Guide Pins Type S-300
7.1The Triplex system is installed and used under rough conditions. Due to mechanical stress, vibrations and aggressive atmosphere and the equipment needs to be maintained carefully for safe operation.
A functional dry run test is recommended before every anchor handling operation.
The owner is responsible for all maintenance on the Triplex equipment. He must perform his own routines and schedules after the following guidelines.
7.2Checking List – Periodic Control Mechanical / Hydraulic.
Procedure for Personal Safety See Section 1; Have to be Followed!
Recommended Regularity: |
MONTHLY |
1.Dismantle manhole cowers on Shark Jaw and Guide Pins.
2.Check H.P. hoses, pipes and fittings. Poor H.P. hoses to be changed.
3.Check that all bolts are properly tightened.
4.Check that link joints are over centre when jaws are in locked position. See drawing B-2209.
5.Check wears on jaws, rollers and bearings. Repair and change where necessary.
6.Movement of bolts and link joints to be controlled under the function test. Look carefully for cracks and deformations.
7.Check sea water drain pipes from Shark Jaw and Guide Pins.
8.Check oil lever in hydraulic oil tank.
9.Starts pump and check that hydraulic pressure raise to max. working pressure (175 bar).
10.Check accumulator nitrogen pressure: 35 Bar.
It’s important first to empty the accumulators for oil by opening the ball valve on the power unit. Then connect gas-filling equipment according to accumulator precharging procedure.
M:\ANCHOR HANDLING\Course Material\Training Manual New\Chapter 06\1.0 TRIPLEX-Shark Jaws.doc
Chapter 06 |
Page 18 |

MTC
Anchor Handling Course
11.Auxiliary equipment as lubrication system to be checked according to the grease system manual. (LINCOLN)
12.Check that gaskets for manhole covers are in good condition.
13.Fit all manhole covers.
7.3Checking List – Periodic Control Electrical
Procedures for Personal Safety see Section 1. Have to be followed!
Recommended Regularity: |
MONTHLY |
1.Switch power off.
2.Perform Visual inspection for mechanical damage on:
-Junction boxes, control panels and cabinets.
-Cables.
-Indicators and switches.
-Electrical components mounted on the entire Triplex equipment / delivery.
3.Open every electrical cabinet, panel and boxes one by one, inspect for damage and heat exposure.
4.Control that all components are firm fastened, and relays are firm in their sockets.
5.Screw connections for every electrical termination to be carefully tightened.
6.Damages and other un-regularities must corrected immediately.
7.Power on, and perform complete functional test programs:
-Normal operation of all functions.
-Quick release.
-Emergency release.
8.Check emergency power (24 V) to junction box.
9.Remount all panels and doors / covers.
M:\ANCHOR HANDLING\Course Material\Training Manual New\Chapter 06\1.0 TRIPLEX-Shark Jaws.doc
Chapter 06 |
Page 19 |

MTC
Anchor Handling Course
7.4 Testing without Load – Yearly Testing.
Checklist |
Control |
Motor/pump |
|
(Accept with OK) |
Panel Bridge |
starter |
|
1 |
Remote pump start |
|
- |
2 |
Remote pump stop |
|
- |
3 |
Local pump start |
- |
|
4 |
Local pump stop |
- |
|
5Pump lamp auto flicker
6Emergency stop
7Wire lift pin up
8Wire lift pin down
9Starboard jaw close
10Starboard jaw open
11Port jaw close
12Port jaw open
13Jaws close simultaneously
14Jaws open simultaneously
15 |
Alarm light jaws open |
|
JAW |
16 |
Lock pressure lights |
|
POSITION |
17 |
Jaw in position lights |
|
ACCEPTED |
18 |
Jaw in position accepted |
- |
|
19Jaws locked light
20Guide pins up
21Guide pins down
22Towing pins up
23Towing pins down
24Emergency release
25Quick release (Jaws only)
26Reset Quick release buttons
27Oil temperature high alarm light
28Oil level alarm light
29Emergency power supply junction box connection (193-194)
30Emergency power supply control panel bridge connection (77-78)
31Jaw in lock position marks in line check, starboard
32Jaw in lock position marks in line check, port
7.5 Load Test – Emergency Release – 5 Year Control.
Wire with required strength to be locked in the Shark Jaw. Make emergency release with a load of 90 tons on the wire (Jaws).
First test: |
With the pump running. |
Second test: |
With the pump stopped and accumulators fully loaded. |
M:\ANCHOR HANDLING\Course Material\Training Manual New\Chapter 06\1.0 TRIPLEX-Shark Jaws.doc
Chapter 06 |
Page 20 |

Maersk Training Centre A/S

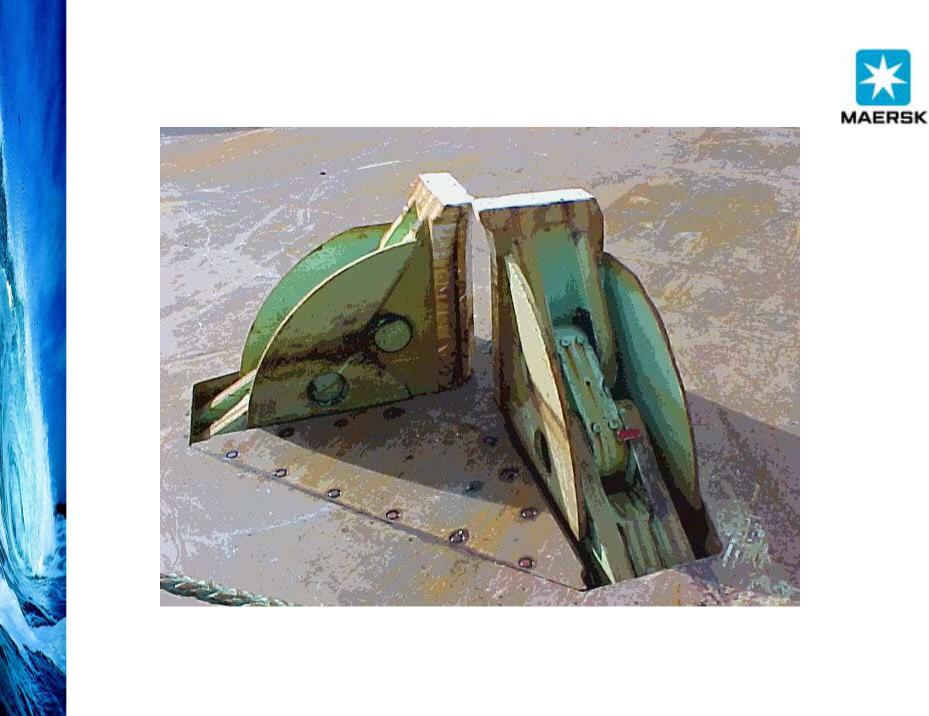

“In closed / locked position” View from astern of Jaws.
Triplex Shark Jaw System
Anchor Handling Course, chapter 6
