tails throughout the design and planning of the crossing.

The rounded corners and reduced bolt connections of the main towers' columns and beams, as well as the configuration and surface finish of the anchorages, resulted from aesthetic considerations. The graceful configuration of the bridge is illuminated at night by white, green and coral pink lighting. The lighting pattern varies with the seasons and times of day. For its illu-

mination design, the Rainbow Bridge was awarded the Paul Waterbury Award of Distinction for Outdoor Lighting by the Illumination Engineering Society of North America.

Owner/Engineers: Metropolitan Expressway Public Corp. (MEPC), Tokyo

Construction duration: 6.5 years Service Date: August, 1993

THE TÄHTINIEMI BRIDGE, FINLAND

Esko Jarvenpaa, Technical Dir. Pekka Pulkkinen, Civil Eng. Suunnittelukortes AEK Ltd, Oulu, Finland

Reiner Saul, Managing Dir. Leonhardt, Andra and Partner, Stuttgart, Germany

Introduction

In 1988 the Finnish Roads Administration organised a design competition for a technically advanced bridge which would adapt well to the lake landscape near the city of Heinola. Heinola is one of the most beautiful cities in Finland, about 130 km north of Helsinki on the route to a lake area where many vacation cottages are located.

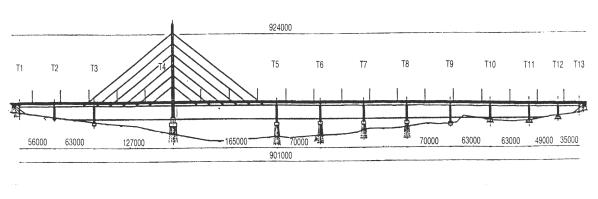

The winner of the competition, now known as the "Star of Heinola", is a single-pylon cable-stayed bridge (Figs. 33, 34). It is the largest bridge in Finland, with a total length of 924 m. The

main span is 165 m and the width of the deck varies from 22 to 30 m.

Fig. 33

Design Competition

The competition was limited to four Finnish bridge engineering companies. The design brief was very demanding. Among the most important parameters were the site, the difficult foundation conditions, the curvature of the roadway and the need to maintain freeflowing marine traffic, including a busy logging channel. Maximum water depth at the site is 24 m, and the bridge is situated in a natural lake landscape, near the town.

Ten proposals were delivered to the competition jury. Five were traditional composite girder designs; one was a

193

single pylon design and three were

struts in the cross sections of two steel

double-pylon cable-stayed designs.

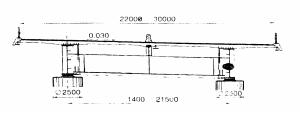

girder designs for this type.

There was also one truss bridge pro-

The cross section alternatives for the

posal.

cable-stayed bridge designs were a

In the superstructures of the composite

concrete box girder, a composite gird-

girder bridges, reinforced compression

er, a composite box girder and a com-

slabs were used in the areas of the in-

posite slab beam which was pre-

termediate supports, and longitudinal

stressed in two directions.

prestressing in the deck slab. Due to

The foundation solutions were very

the considerable width of the deck that

similar in all bridges. In deep water,

was required, there were inclined steel

composite steel pipe piles were used.

Fig. 34

Other supports were founded on soil or

Deviating from Finnish load specifica-

rock. The diameter of the piles varied

tions, the full traffic load can be car-

from 700 to 1500 mm.

ried on one side of the bridge deck

The winning design, with its single

when there is simultaneously a special

105 m high pylon, serves as a dramatic

heavy truck on the other. If the cables

gateway to the lake district of Finland.

have to be changed in the future, only

Its cable-stayed spans are placed over

one edge lane has to be closed. Also,

the open lake so that the heavy marine

the pylon was designed for greater

traffic can operate with minimal ob-

wind loads than specified in the exist-

struction.

ing code. Crash loads of ships have

Bridge Design

been taken into consideration in the

design of the intermediate support.



The five middle supports are founded

The client wanted to assure adequate

on composite steel pipe piles; other

traffic-handling capacity of the bridge

supports are founded on soil or rock.

far into the future as well as under ex-

The steel piles were designed as a

ceptional circumstances. Thus, it was

composite structure with a 4 mm thick-

decided that the bridge should be de-

ness of the steel pipe wall allowed for

signed for far heavier traffic loads than

corrosion. The diameter of a pile is 813

current Finnish load codes specify.

mm and thickness is 16 mm. Rein-

194

forcing bars are placed in the uppersection of the piles.

The cross section of the deck is a traditional composite structure of two open girders. The girders are 3.2 m high I- beams (Fig. 33). There are crossbeams at 7 m centres. On the crossbeams there is a 1 m high secondary longitudinal girder. In the north part of the bridge, where the deck is 30 A wide, there are two secondary girders.

The cable crossbeams are inclined to the cable direction. Between the main girders, the cross section of the cable crossbeam is an open I-beam. The girders are stiffened with steel bars. Outside the main girders, the cable crossbeam is a composite box girder.

In the competition proposal, the pylon was a steel structure. In the general design, the costs of steel, composite and concrete pylon were compared. The concrete pylon proved to be the most economical.

The pylon is formed of two T-shaped hollow concrete towers which are joined together by two crossbeams. There is an elevator inside one tower and stairs inside the other. The horizontal geometry of the road has a curvature of R = 4000 m. This caused large horizontal forces on the towers. Therefore, the pylon was not placed centrally to the deck cross section, but with an eccentricity of 0.6 m. Due to this placement, the horizontal forces, and hence, the number of steel piles decreased considerably.

The bridge has 24 factory-fabricated parallel wire cables. The cables consist of 7 mm steel wires (253-403/cable) injected with grease inside a high den-

sity polyethylene pipe that is covered with white Tedlar tape. The pylon and cables are illuminated at night.

The fixed bearing of the bridge is at the southern abutment. It is a hinged structure, where horizontal forces are transferred large steel bars.

Construction

The piling and the concreting of the foundation slabs and columns took 14 months. The joint welding of the steel girder sections and the launching were completed in one year. The largest concrete works, such as towers and deck slabs, were placed in summer, because the temperature in winter can be as low as -25 °C.

At the beginning of the construction period, the design for the pile foundation was changed to a caisson structure. The caissons were built in a dammed trough on the north side of the bridge. The caissons were floated into position and the piling work was done through access holes in the caisson slab. Finally, the piles and the inner part of the caisson were cast in dry conditions. Except for the slab of supports T3 and T9, all casting work on the substructure was done in dry conditions. The casting of pile slabs succeeded well and there were no faults typical of underwater concrete casting. The steel girders of the superstructure were launched from both abutments and joined by welding between supports T5 and T6. Three auxiliary piers had to be built for the cable:stayed spans during launching. The top of the girder was lifted on a pontoon when

195

the spans exceeded 70 m. The launching bearings were vertically adjustable because the girder was very stiff. The longest beam sections were 42 m long and the maximum weight was almost 80 t.

The bridge was originally designed using steel grade Fe 355 E, but the steel contractor and steel manufacturer proposed to change the steel grade of the support sections of the girder to a new thermomechanically manufactured S 420 ML steel. Using this material, the contractor slightly reduced the weight of the girder and benefited from the superior welding properties of the new steel grade. The total amount of steel in the superstructure is about 50501.

The towers of the pylon were cast using a climbing formwork, with the height of one casting section being 4.15 m. The longitudinal reinforcing bars were jointed with screw sleeves.

The crossbeams between the towers and the cable anchor areas were pre: stressed. The surface of the concrete tower had to meet stringent quality requirements. A textile covering was placed on the formwork surface to enhance the strength of the concrete surface and to reduce air blisters. A green concrete paint was applied to the surface of the pylon.

Construction of the pylon was complicated because it has three inclined walls. Therefore, the scaffolding had to be adjusted at every stage. The reinforcing of the cable anchor area was difficult because of restricted space. The temporary support structure of the

upper crossbeam was also difficult to install and there were problems to stabilise it. Nevertheless, the pylon was completed on schedule and all casting work was completed before winter.

The deck slab of the superstructure was cast using two movable scaffolding units. The longest casting section was 24 m. The slab was prestressed transversely in two equal stages.

The stay cables were installed from the bottom upwards. Cable stressing was accomplished using four jacks at the level of the deck slab. The cables were stressed in pairs. The total weight of stay cables is 214 t. They were tested against fatigue and ultimate load, the test cable being the largest cable of the bridge. In the fatigue test, where a 5 m long test Cable was loaded 2 million times with a stress variation of 193 MPa, only 9 wires broke. After this test the same cable was stressed up to the breaking load, 24.6 MN.

Client:

Mikkeli Road District

Design:

Suunnittelukortes AEK Ltd, with Leonhardt, Andra and Partner

Main contractor: WT Corporation Ltd

Steel contractor: PPTH Steel Ltd

Construction duration: January 1991 to November 1993

196

THE PITAN BRIDGE, TAIWAN









Kwong M. Cheng







- meet all freeway design and perfor-

Pres.,

OPAC Consulting

Engineers,

mance requirements of the Northern

San Francisco, CA, USA





Taiwan Second Freeway

Introduction







- be aesthetically pleasing, construc-







table, and economical











- require minimum maintenance.

To alleviate traffic congestion near

The following factors were considered

Taipei, in 1985 the Taiwan Area Na-

in the selection of the bridge type:

tional Freeway Bureau planned the

-

Structural systems issues such as

construction of the 108 km long North-

bridge piers, span lengths and ar-

ern Taiwan Second Freeway. The ma-

rangement,

foundations, vertical and

jority of the Second Freeway's align-

horizontal clearances, capacity to resist

ments are on grade, on embankments,

horizontal forces and seismic actions,

in tunnels, or on viaduct structures. At

etc.



several locations,

however,

obstacles

-

Aesthetic issues such as the overall

were identified that required special

appearance of the bridge, its com-

bridges. The Pitan Bridge spans one of

patibility with the surrounding land-

these areas.







scape and with existing built facilities

The Pitan Bridge, actually two nearly

- Construction issues such as the con-

parallel bridge structures, is located

struction method, equipment, con-

about 15 km south of Taipei. It con-

struction time and the capabilities of

nects typical low-level viaducts to

a

local contractors

tunnel. Both bridge units have a total

- Cost issues such as the cost of relat-

length of approximately 800 m, a 750

ed

works,

of maintenance and the

m radius curvature and a slope of ap-

cost of the bridge itself.

proximately 1%. The Pitan Bridge has

Four bridge types consisting of varia-

become a landmark in this suburban

tions on girder-and-arch designs were

area of Taipei.







identified as potentially meeting the

Selection of the Bridge Type



above design considerations.



The selected bridge type consists of a











post-tensioned cast-in-place concrete

The design of the Pitan Bridge was

box girder bridge deck supported on

based primarily on the 1983 AASHTO

delta-shaped reinforced concrete box

Standard Specification for

Highway

piers, which are joined together at the

Bridges, the 1987 AASHTO Design -

centre of the main span to form an

and

Construction

Specifications

for

arch. This scheme adapts well to the

Segmental Bridges (No. 2 Draft), and

constraints of the site and provides a

local design codes. Among the general

stiff, strong bridge with a clean, effi-

constraints and concerns that guided

cient, and very modern appearance.

the design of the bridge, it had to:









197

Basic Layout

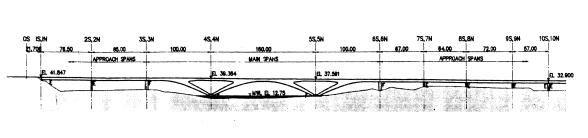

spans totalling 781.5 m, with a 160 m



main span. The northbound bridge has

The two almost parallel bridge struc-

an additional simple span of 21.7 m

tures have nearly identical structural

(Fig. 35).

layouts. They each consist of nine



Fig. 35

Expansion joints have been kept to a

determine the dimensions of the main

minimum, located only at the extreme

structural elements of the bridge: the

ends of the structure. The four main

cross section, the longitudinal system,

bridge piers (3, 4, 5 and 6) are fixed to

the pier shafts, footings and piles.

the girder and footings with monolith-

Superstructure Design

ic, moment-resisting connections. The

smaller piers and the abutment are



fixed to their footings only and support

Detailed design and analysis made use

the girder through bearings that are

of more refined analytical tools in or-

fixed transversely, having some lim-

der to verify the preliminary design.

ited freedom-to slide longitudinally.

The following tasks were performed:

This combination of few expansion

- development of structural models for

joints and high pier fixity was evaluat-

service-load analysis

ed for serviceability under the required

- evaluation of design values for mo-

seismic excitation, as well under the

ment and shear

influence of creep and shrinkage in the

- transverse and three-dimensional

concrete, and temperature change in

considerations

the structure. The piers and founda-

- pier moments, shears, and axial

tions provide enough flexibility so that

forces

the time-dependent strains and tem-

- thermal effects.

perature strains of the concrete, accu-

The bridge superstructure consists of a

mulated over the entire girder length

single cell box girder (Fig. 36). The di-

between expansion joints, cause ac-

mensions of the box girder were de-

ceptably small bending stresses in the

signed to comply with the strength re-

piers and axial stresses in the girder.

quirement as well as provide space to

The preliminary design made use of

house the necessary prestressing ducts.

simple and rational analytical tools that

The main span girder depth varies

have proven reliable for many struc-

from 8.882 m at the face of the delta-

tures. The following were considered

shaped pier to 3.5 m at mid-span, and

at this stage of the design in order to

is prestressed longitudinally with can-

198

tilever tendons in the top slab and con-

mid-span and over the pier to resist su-

tinuity tendons in the webs. All pre-

perimposed dead load, live load, creep,

stressing is grouted in ducts embedded

and temperature moments. Each of

in the slabs and webs of the girder.

these tendons extends over the full



length of a span, and is anchored in the



diaphragm walls over the pier.



The deck transverse prestressing is di-



mensioned to resist transverse bending



from dead load and live load. The gird-



er cross-section reinforcement includes



a grid of mild steel bars in each direc-



tion on each face of each structural el-



ement.



The delta-shaped piers are designed to



reduce the length of the main span,

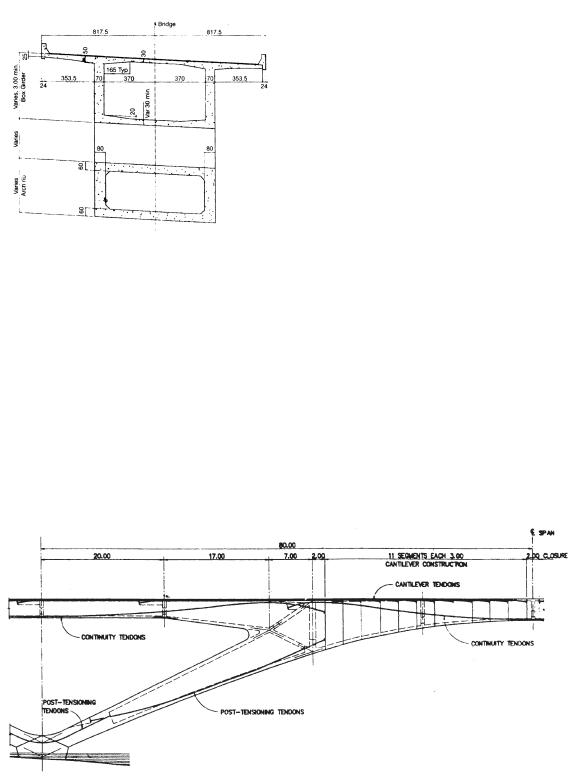

Fig. 36

thus allowing the relatively slender

The top deck longitudinal prestressing

box girder to meet the strength and

is dimensioned to resist all structural

stiffness demands on this bridge. They

dead loads during cantilevering, as

are designed as wall-type elements

well as construction loads and the

with post-tensioning to provide a re-

weight of the travelling formwork. All

sidual compressive stress under com-

anchorages are located in the well-

bined axial force and bending for all

confined and reinforced intersection

service load conditions. The schematic

fillets at the tops of the webs.

prestressing layout of the main span is

The web longitudinal prestressing is

shown in Fig. 37.

dimensioned to provide adequate mo-

Seismic Analysis and Design

ment capacity and stress control at

Fig. 37

199

Initial, seismic analyses were performed in accordance with the local seismic design criteria. These analyses provided controlling conditions for design of the piers and foundations.

A more refined analysis using earthquake response spectrum developed for the vicinity of the site, was used later to verify structural dimensions and reinforcement requirements.

Substructure Design

Each pier consists of a four-walled cellular reinforced concrete shaft, heavily reinforced to form a ductile cellular element. All fixed piers participate in providing the required capacity to resist seismic and horizontal forces. For transverse seismic loads, the piers behave as cantilevers, with significant moments developed at the bottom only. For resisting longitudinal seismic excitation, the main piers behave as members in a rigid frame. The creep, shrinkage, and temperature deformations of the superstructure are adequately accommodated in the monolithic piers by the flexibility of the foundations and the pier shafts.

The basic cross section of the main piers continues through the depth of the box girder cross section to provide diaphragms capable of developing the plastic moment of the pier into the girder. These diaphragms also provide a convenient location for anchorage of the longitudinal prestressing tendons in the superstructure.

The abutment is designed as a conventional cantilever wall which supports the bridge girder on sliding bearings. The footing blocks supporting the piers

were designed for the static dead and live impact loads and the seismic loads such that the movements at the base of the piers are within allowable limits and no plastic hinges develop below the ground surface.

Foundations consist of 2.0 m diameter drilled, cast-in-place, reinforced concrete piles, supporting reinforced concrete footing blocks. The piles, up to 14 m in length, act as friction piles with some limited end-bearing support.

Analysis and Modelling

Constructability will largely determine the success of a project. Therefore, a thirty-eight step stage-by-stage analysis of the bridge was performed to validate the time-dependent behaviour of the construction sequence. The analysis included:

-development of structural computer models for construction procedure

-evaluation of stresses and deflections at critical construction stages

-evaluation of stresses and deflections over the service life of the bridge. The bridge was modelled using a commercially available general-purpose structural analysis program which is capable of static and dynamic analysis of finite element models for a wide range of structure types.

All important structural features of the bridge were modelled, including the piers, the box girder, and the deltashaped piers. The girder was modelled as a line of frame elements representing the entire cross section, oriented along the centroidal axis of the prototype girder. The piers were modelled

200

similarly, including semi-rigid elements in the pier-girder intersection. The intersection zone between the delta-shaped piers and the girder was modelled by a separate finite element

model in order to capture the stress distribution between the diaphragms and the webs in this area.

ROOSEVELT LAKE BRIDGE, GILA COUNTY, ARIZONA

Maurice D. Miller, Civil Eng.

ing hundreds of miles to the route. Al-

HTNB Corp., Kansas City, MO

though traffic congestion was im-

Crossing Roosevelt Lake

portant, the deciding factor for the new

Roosevelt Lake Bridge was flood pro-



tection. When the US Bureau of Rec-

Located in Gila County, a rugged area

lamation raised the dam by 23.5 m to

of east-central Arizona, Roosevelt

provide additional protection to Phoe-

Lake is a hydroelectric reservoir used

nix and the Valley of the Sun, it re-

for flood control, irrigation and recre-

moved State Highway 188 from the

ation. It is midway between the cities

dam.

of Globe, which is the county seat, and

Bridge Type Selection

Payson, in a ranching and recreational

area. State Highways 88 and 188 con-



nect the two major cities. From Globe,

Located about 305 m upstream of the

Route 88 winds northwest through de-

dam, the new Roosevelt Lake Bridge is

sert canyons and along the south-west

just below the confluence of the Salt

shore of Roosevelt Lake to a masonry

River and Tonto Creek. Here, the Salt

dam, where it connects with Route 188

River just begins the erosion of its

and continues west and north to Pay-

canyon through the Mazatzal Moun-

son.

tains. The steep-walled features of the

The one-lane road traversing the dam

canyon were ideal for the construction

across Roosevelt Lake had not been

of the world's highest masonry dam,

improved since construction of the -

creating a lake 300 m wide and 60 m

dam in 1911. Travel across the dam

deep at the proposed crossing.

was slow and treacherous, with abrupt

The Arizona Department of Trans-

90° blind corners. When two cars met

portation based its selection of the best

on the dam, one had to yield the right-

type of bridge for the crossing on eco-

of-way and back up, a gesture that was

nomics. Because of the steep valley

not always made willingly by the local

walls and the deep valley floor, under-

ranchers.

water foundations were determined to

Because of the narrow and crooked

be too costly. The two-lane bridge

route over the dam, vehicles over 9 m

would have to span the lake with foot-

in length were prohibited. Commercial

ings on each shore. Two engineering

traffic between Globe and Payson was

firms prepared complete construction

forced to detour through Phoenix, add-

plans for two alternatives: a steel box-

201

rib-through-arch and a concrete stayed girder bridge.

The box-rib-through-arch was selected for the steel alternative based on an indepth study of three steel bridge types: trussed-through-arch, box-rib-through- arch, and cable-stayed girder. The twisting alignment required for the mountainous terrain made it difficult to get a tangent alignment long enough to accommodate minimum-length back spans for the cable-stayed and trussed arch bridges.

The arch span was the most economical. It adapted readily to the curved alignment of the approach structures and had superior aerodynamic properties. The welded steel arch was the overwhelming favorite of most bidders. It was bid at 30% less than the concrete alternative.

Arch Rib Design

Existing terrain and future lake levels were important factors in establishing the arch rib geometry. The arch springline is at Elevation 649.5 m, well below the 200-year flood elevation of 663 m. To keep the steel arch above water, the lower 158 m of the arch rib is made of concrete. The resulting composite steel-concrete structure consists of the following sections: 21.6 m of concrete rib, 323 m of steel rib, and 21.6 m of concrete rib, for a total arch rib length of 366.4 m and an arch span of 329 m.

The steel and concrete portions were made continuous by anchoring a base plate at each of the steel-concrete con-

nections. This required 32 MN of prestress force at each base plate.

The geometry of the entire arch rib optimizes the use of material through the length of the rib. The depth of the steel box section varies from 2.44 m at the crown, where compressive forces are the smallest, to 4.27 m at the base, where compressive forces are the greatest. The shape of the arch rib was also established to minimize the dead load bending stress in the arch. The resultant shape is defined by both second order and fourth order curves, making the entire arch appear smooth and continuous.

The steel arch rib section is made up of two 1.2 m-wide flanges with two web plates that vary from 2.44 m at the crown to 4.27 m at the base plate. The webs of the box section are stiffened by two T-sections welded to each web. The stiffeners are continuous and participate fully in carrying the various loads. Sixteen longitudinal fillet welds, over 13.4 m long, were required to connect the flanges and the stiffeners to the webs.

Stability against global buckling and transmission of wind loads for the arch rib, which is 15.2 m center-to-center, was achieved through the use of a K- bracing system fabricated from structural tubing and welded box sections. The selection of the K-bracing was based on both first-cost and life cycle costs. The K-bracing required 901 less steel and reduced wind deflections to half as much as those caused by a comparable Vierendeel system. The closed tubular sections were selected to minimized corrosion due to entrap-

202

Соседние файлы в предмете [НЕСОРТИРОВАННОЕ]
